Identify flow of DEX volume through frontend
The dex.orderflow
table provides transaction-level swap data to illustrate DEX transaction volumes through frontends.
The dex.orderflow
model builds upon swap events identified from both dex.trades
and dex.aggregator_trades.
The orderflow table aggregates swaps by transaction hash. The exception here is cow-protocol swaps, which are treated as individual transactions. Within each transaction, we roll up all swaps that are routed by aggregators and all swaps that are executed by pools.
The usd_volume
of the swap is determined by the max usd_amount
of the swap within the entire transaction.
The volume and swaps executed by all dex pools are aggregated in the liquidity_details
column. For volume and swaps routed through dex aggregators, they are wrapped in the aggregator_details
The orderflow model utilises both contract interactions and the integrator field in dex.aggregator_trades
to identify the most probably frontend where the transaction was executed.
Labelling based on Contract Interaction
Internally, Allium maintains a mapping of key telegram bots, MEV contracts, and aggregator routers which we use to label the transaction by the most probable frontend by the transaction’s to_address

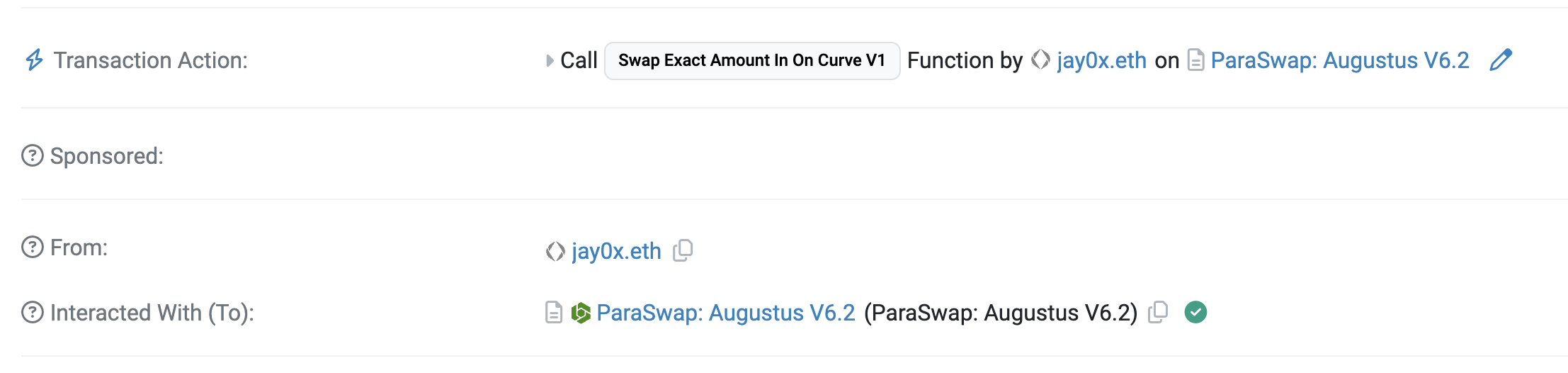

The to_address
would be the ParaSwap Augutus Router.
Labelling Based on Event Log
In the event logs of certain transactions, the aggregator may emit fields which tell us where the swap source is executed from. This can be from the details of the swap referrals or the actual name of the frontend that was used.
In OpenOcean’s event swap log, the referrer
field indicates the fee recipient and frontend integrator where the swap was executed from.
In Kyberswap Aggregator’s client data event log, the hex-decoded data will tell us the source of the swap: {"Source":"dextools","AmountInUSD":"27.418064752878504","AmountOutUSD":"25.55357350955812","Referral":"...}
These fields are parsed and used to label the integrator
fields in the dex.aggregator_trades
model.
Heuristics to determine frontend
A combination of integrator and contract labels is used to infer the frontend. The orderflow currently uses the following logic. Users can use the dex.unhydrated_orderflow
to tune their labelling logic.
Unique Key: unique_id
Column Name | Data Type | Description |
---|---|---|
frontend | VARCHAR | The frontend interface used for the transaction |
block_number | BIGINT | The block number in which the transaction was included |
block_timestamp | TIMESTAMP_NTZ(9) | The timestamp of the block in which the transaction was included |
transaction_hash | VARCHAR | The hash of the transaction |
transaction_index | BIGINT | The index of the transaction within the block |
swapper_address | VARCHAR | The address of the user performing the swap. For most trades, this comes from the transaction_from_address field in dex.trades / dex.aggregator_trades. However, for UniswapX and CowProtocol swaps, it comes from the sender field instead. |
from_address | VARCHAR | The address initiating the transaction (msg.sender) |
to_address | VARCHAR | The address receiving the transaction |
is_aggregator | BOOLEAN | Flag indicating if the transaction is an aggregator |
usd_volume | NUMERIC | The volume of the transaction in USD |
total_usd_volume | NUMERIC | The total volume of the transaction in USD |
senders | VARIANT | Array of addresses sending tokens in the transaction |
recipients | VARIANT | Array of addresses receiving tokens in the transaction |
user_token_input | VARCHAR | Address of the token the user is selling |
user_token_input_symbol | VARCHAR | Symbol of the token the user is selling |
user_token_output | VARCHAR | Address of the token the user is buying |
user_token_output_symbol | VARCHAR | Symbol of the token the user is buying |
tokens_sold | VARIANT | Array of tokens sold in the transaction |
tokens_bought | VARIANT | Array of tokens bought in the transaction |
integrators | VARIANT | Array of integrator names involved in the transaction |
integrator_tags | VARIANT | Array of integrator contract addresses |
aggregator_source | VARCHAR | Source of the aggregator |
aggregator_usd_volume | NUMERIC | USD volume of the aggregator portion |
aggregators | VARIANT | Array of aggregator contracts involved |
aggregators_count | BIGINT | Count of aggregators involved |
aggregator_details | VARIANT | JSON details of aggregator swaps |
liquidity_source | VARIANT | Array of liquidity sources used |
liquidity_usd_volume | FLOAT | USD volume from liquidity sources |
liquidity_pools | VARIANT | Array of liquidity pool addresses used |
liquidity_pools_count | BIGINT | Count of liquidity pools involved |
liquidity_details | VARIANT | JSON details of liquidity pool swaps |
total_trades | BIGINT | Total number of trades in the transaction |
unique_id | STRING | Unique identifier for the transaction |
